Beacon Pool Renovation Project
We’re pleased to share that the Beacon Pool and spa will soon undergo a comprehensive renovation. This project includes a complete replaster of the spa, removal of the current surface, inspecting the shell for any needed repairs, and applying a fresh new plaster finish. These updates will restore the spa’s surface, improve water quality, and significantly extend its lifespan.
While the pool is not yet scheduled for a full replaster, it will receive key enhancements to maintain its longevity and appearance. This includes an acid wash to refresh the interior surface, resetting the coping, and replacing the deck mastic to ensure structural integrity and visual appeal.
These proactive improvements are essential to preserving the overall health of our aquatic facilities. By addressing surface wear, resetting coping, replacing deck mastic, and completing a full spa replaster, the project enhances the safety, functionality, and overall aesthetics of the aquatic facility. Together, these improvements will ensure a cleaner, more comfortable, and visually refreshed environment for all residents and guests to enjoy.
Project Updates:
9/15/25 - The Beacon Pool facility will be closed beginning September 15 for renovations to begin.

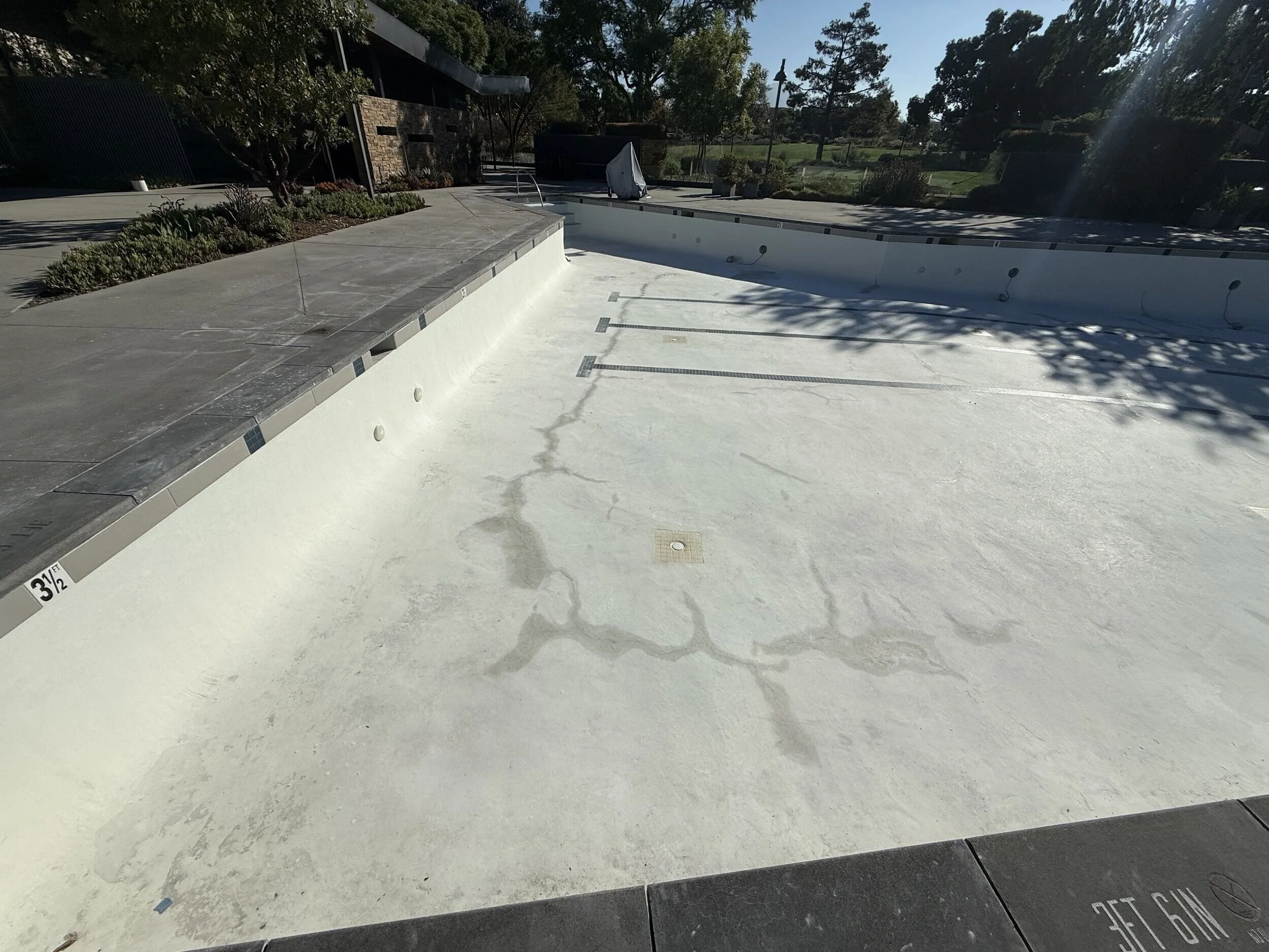

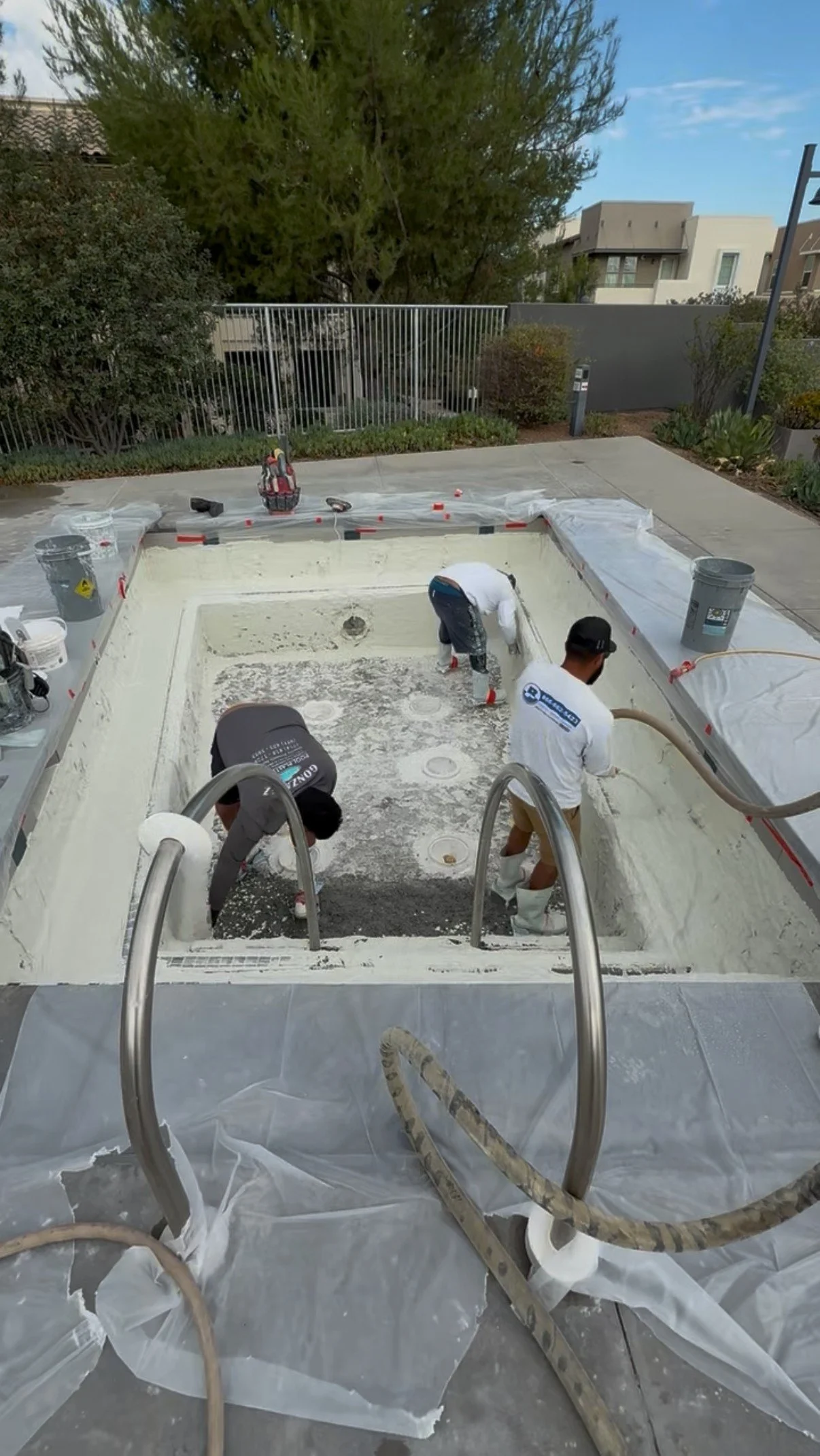

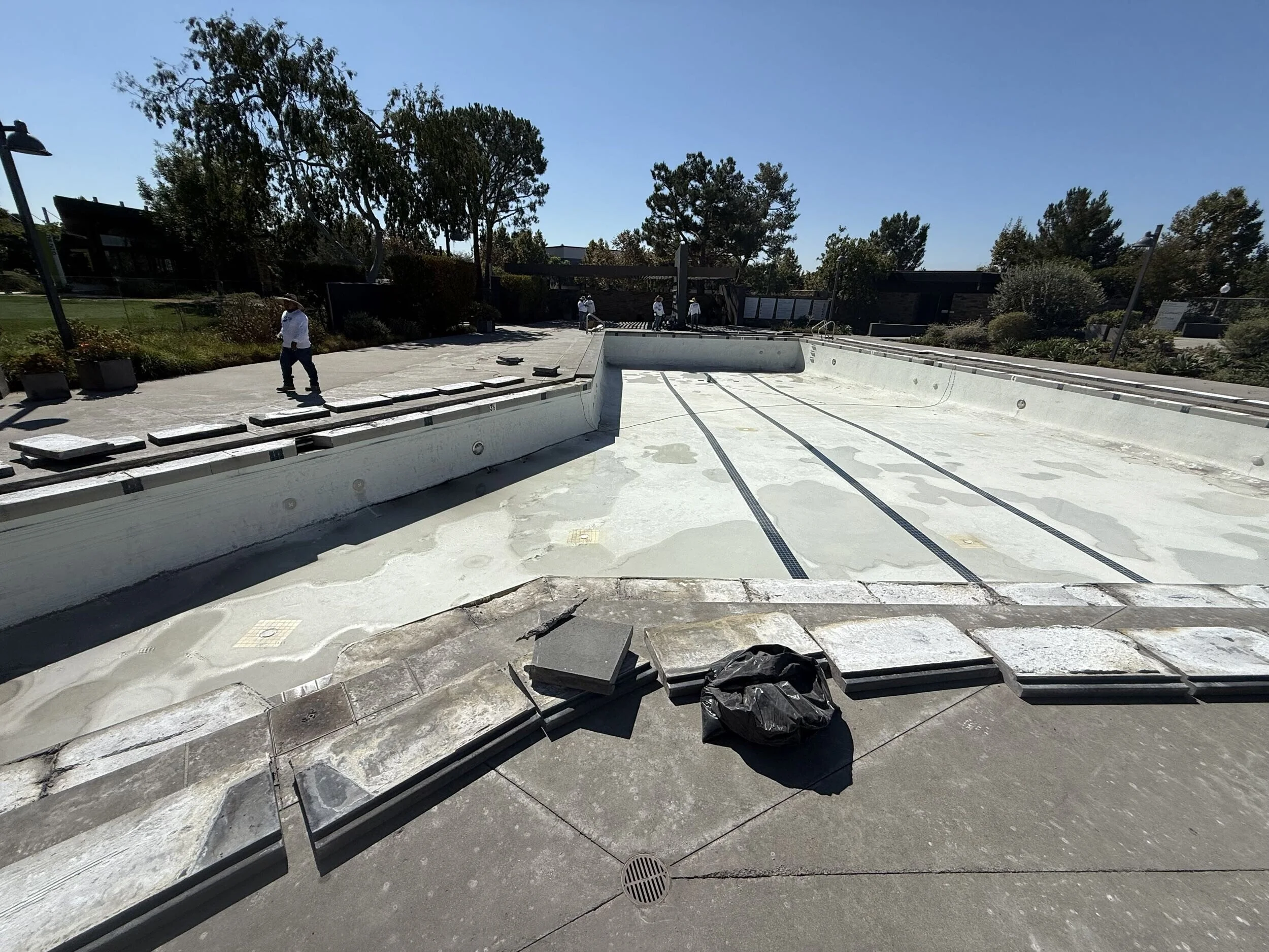

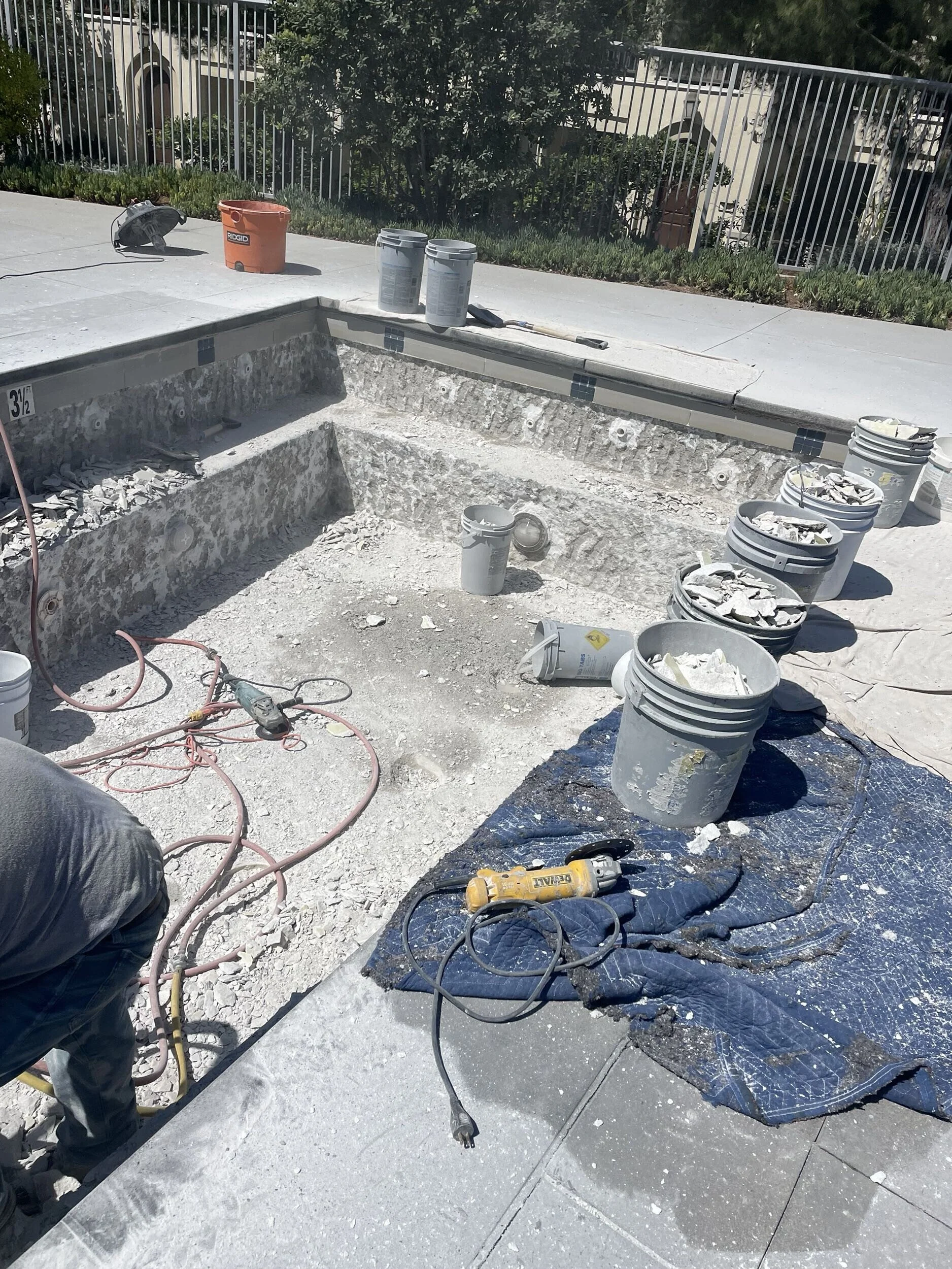

9/15 - The work began with draining the pool and spa, followed by removal of the mastic and coping around the pool. The spa was chipped, and both bodies of water were pressure washed.

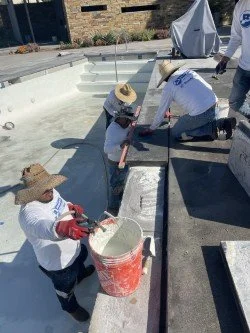

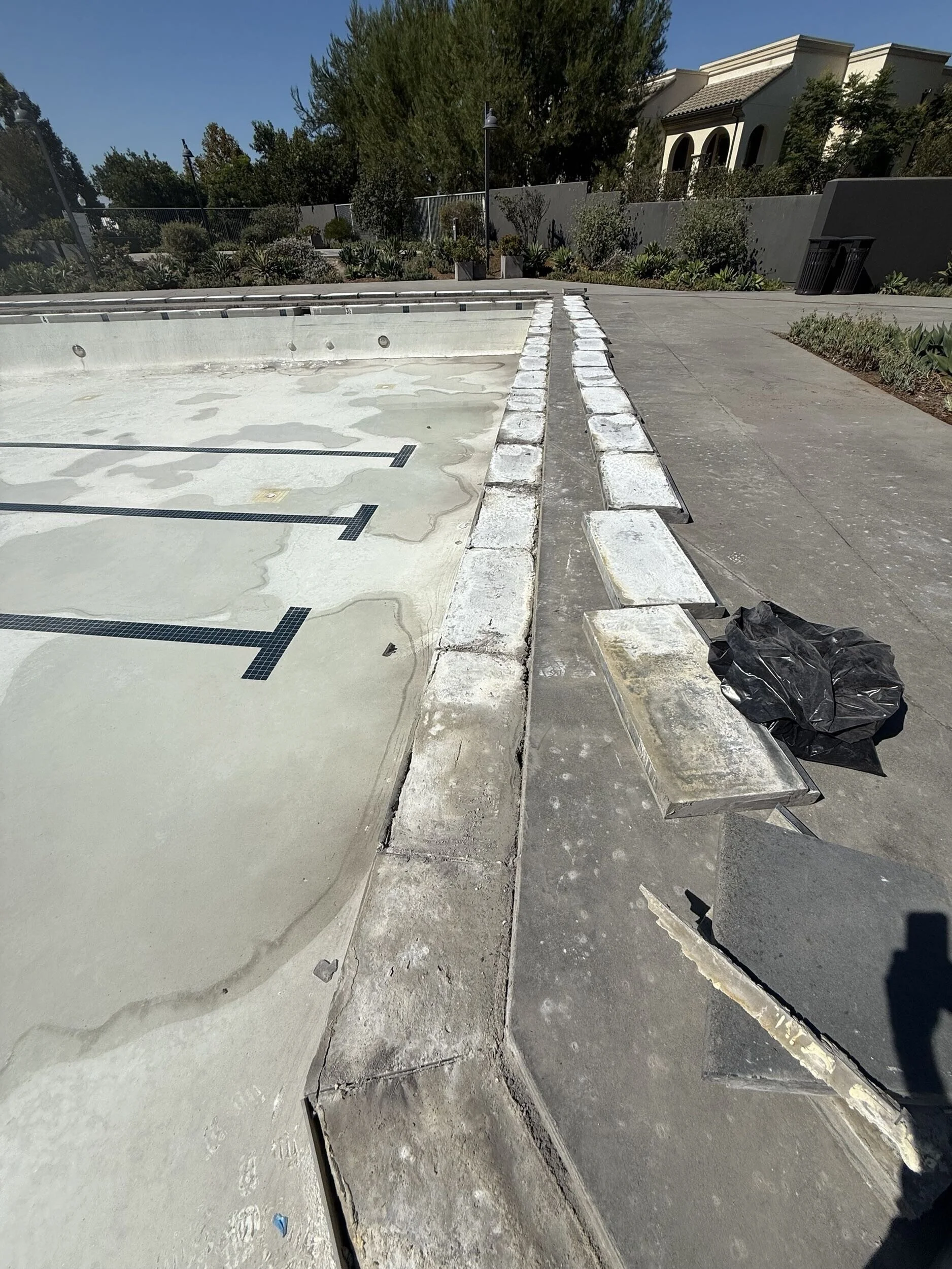

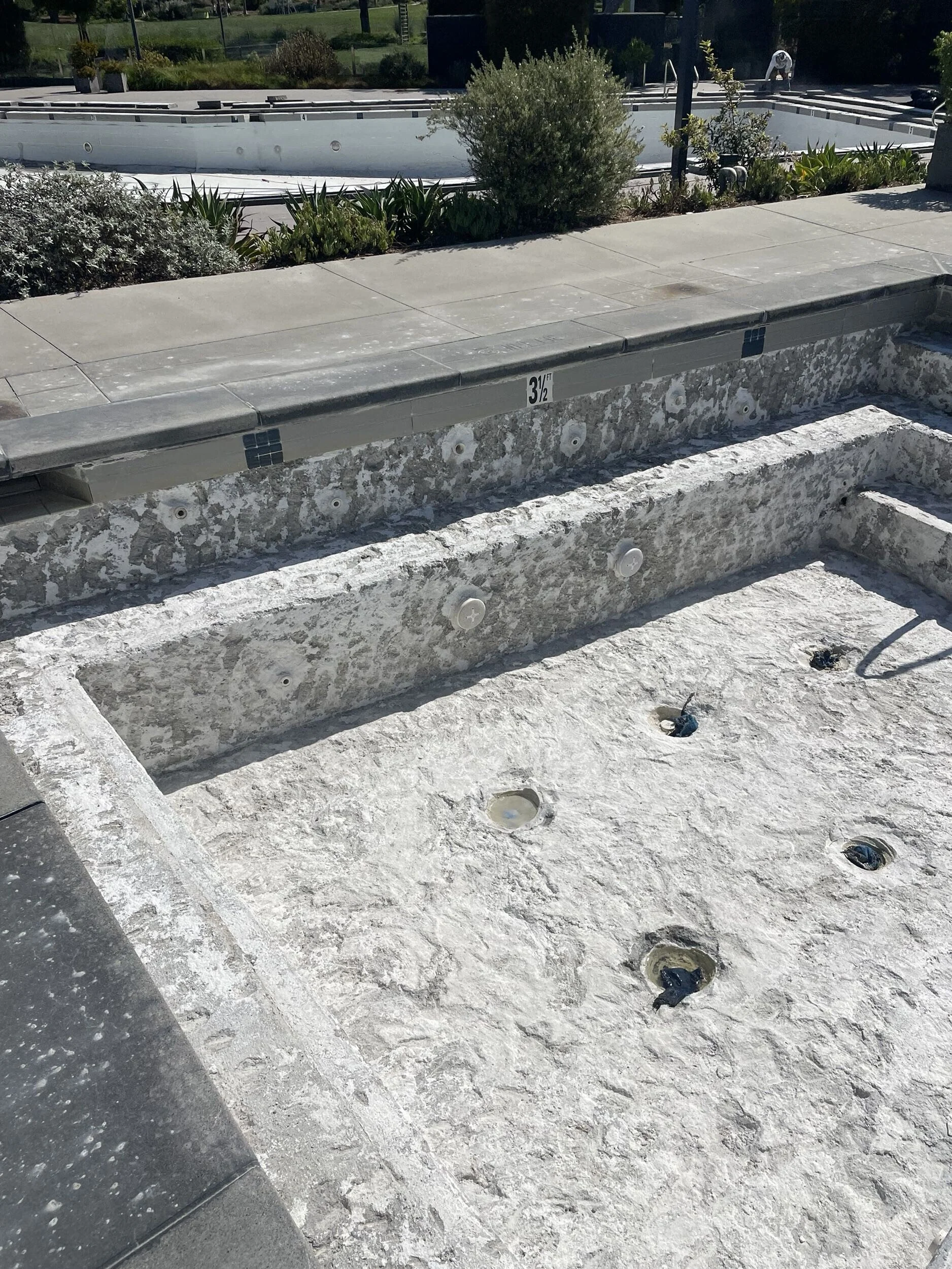

9/22 - The pool and spa coping reset is complete, and the pieces are ready for grouting and Deck-O-Seal reinstallation. Spa drain covers are being installed today ahead of the Health Department’s pre-plaster inspection. Preparation for the trim tile installation is also underway.
9/29 - Tile in the pool and spa has been bead-blast cleaned, trim tile on the spa steps/bench completed, and coping re-grouting is underway with completion expected today. Prep for Deck-O-Seal is in progress with materials onsite, and a Health Department pre plaster inspection is scheduled for next week.

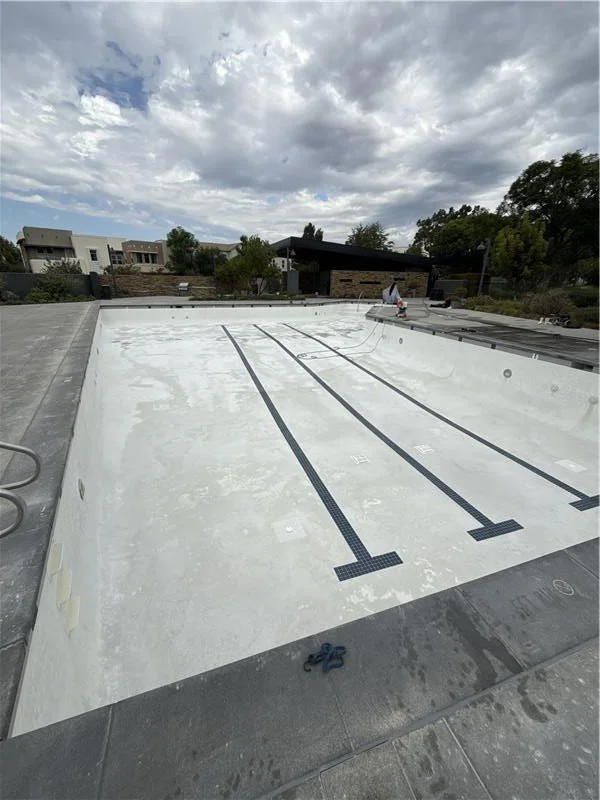

10/6 - Deck-O-Seal installation is complete. Pre-plaster inspections with both the Building and Orange County Health Departments were passed, and work continued with acid washing the pool, epoxy patching skimmers, addressing main drain rust spots, plastering and filling the spa, and installing nano-glass in the pool on Friday.

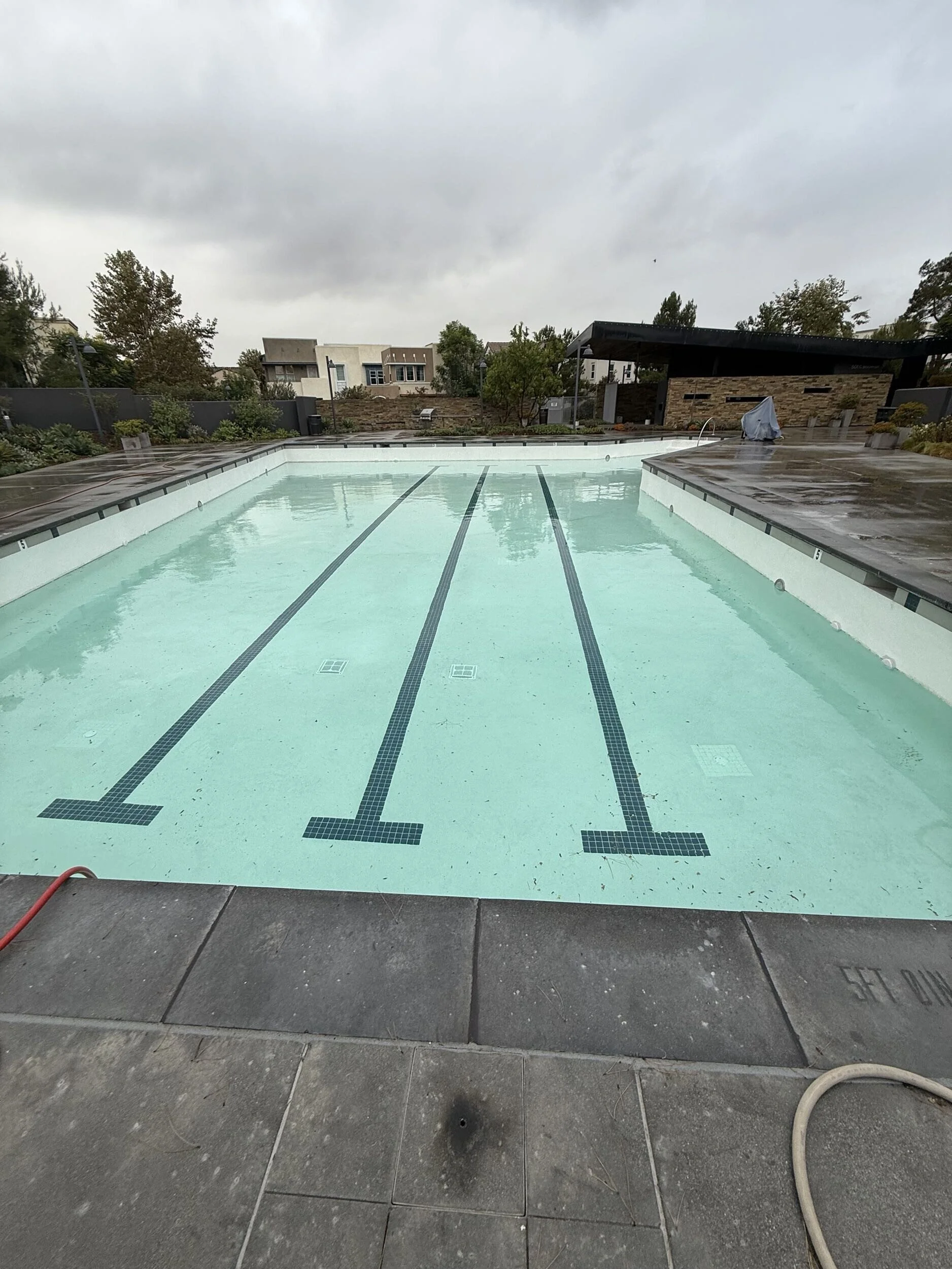

10/13- Pool fill was started and completed. Startup on the spa and chemical balancing for both bodies of water are currently underway. The final inspection with the Health Department is scheduled for next week

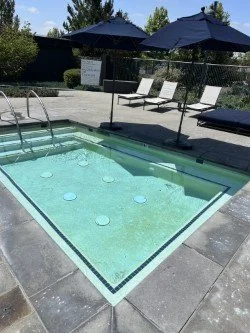

10/20: Chemical balancing was completed this week. Additionally, the health inspector conducted an inspection and passed the facility. Since the spa was replastered, it will need to cure for 28 days before any heat can be applied. The facility will remain closed until the spa has cured and heat can be safely turned on.
