The Pools Resort Renovation Project
Pardon our dust! The Pools Resort facility will be undergoing a major renovation beginning September 8, 2026. This exciting project is part of Great Park Neighborhoods' ongoing commitment to maintaining and improving the community's recreational facilities for residents to enjoy.
The renovation will include the replacement of the paver decking throughout the pool deck, replastering of all five bodies of water, fencing repairs, new pool umbrellas, and repainting throughout the facility. These improvements will not only refresh the appearance of the resort but also help preserve the infrastructure, improve the functionality of the facility, and extend the life of this community amenity.
The Pools Resort is scheduled to close on September 8, 2026, and is currently anticipated to reopen by Memorial Day weekend 2027. During construction, residents are encouraged to enjoy the other Great Park Neighborhoods pools and recreation amenities. We appreciate your patience and understanding as we complete these improvements; timelines may be adjusted as the project progresses to ensure the best possible outcome for the community.
Please see project updates below:

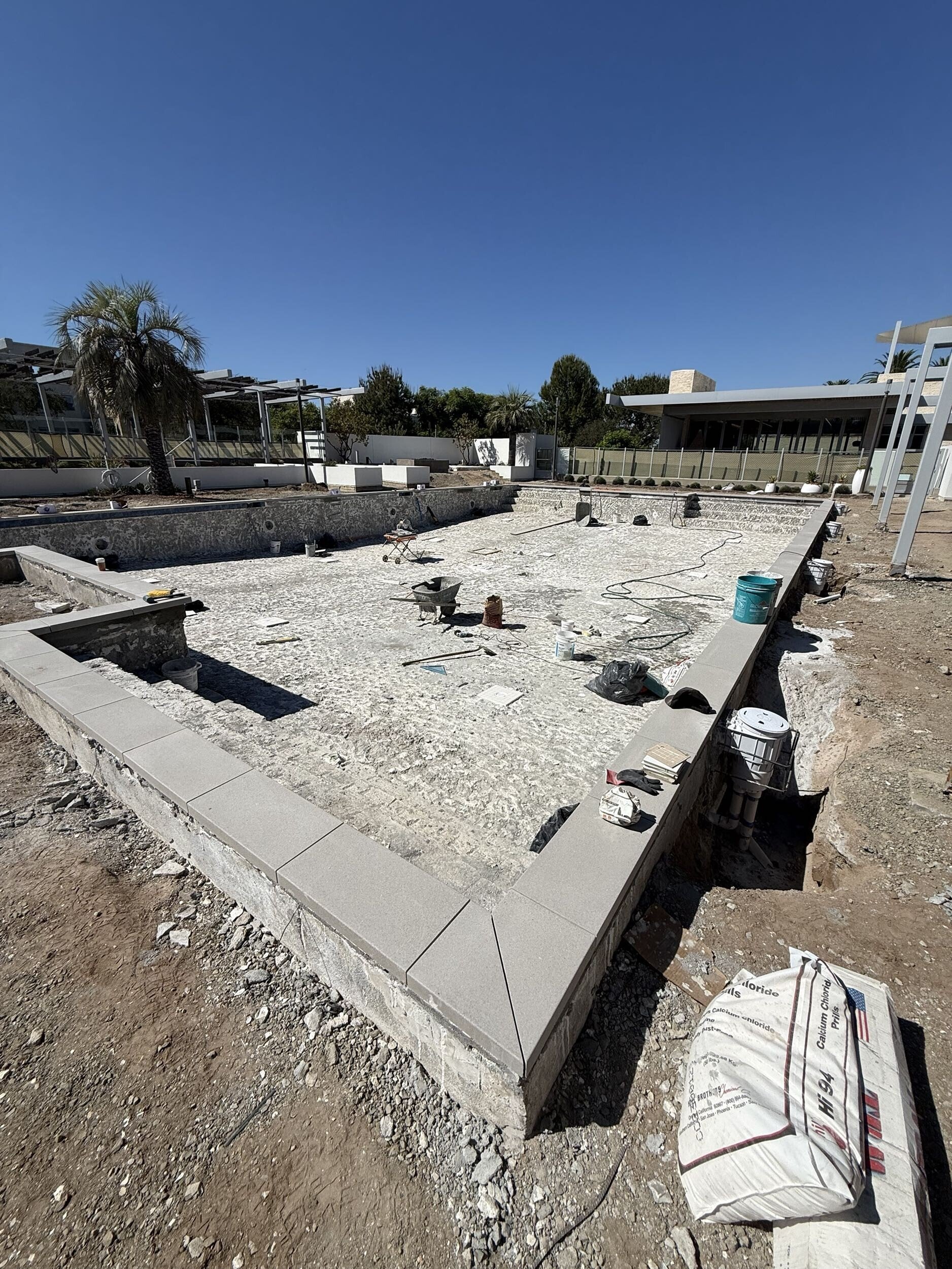

11/20/26 - Plumbing repairs to the shower valves have been completed, and all pool and spa autofill systems have been installed. The project also successfully passed the sub-deck inspection by the health inspector. In addition, the ADA lift footing and mounting bracket have been installed. Looking ahead, paver materials are scheduled for delivery to begin paver installation.

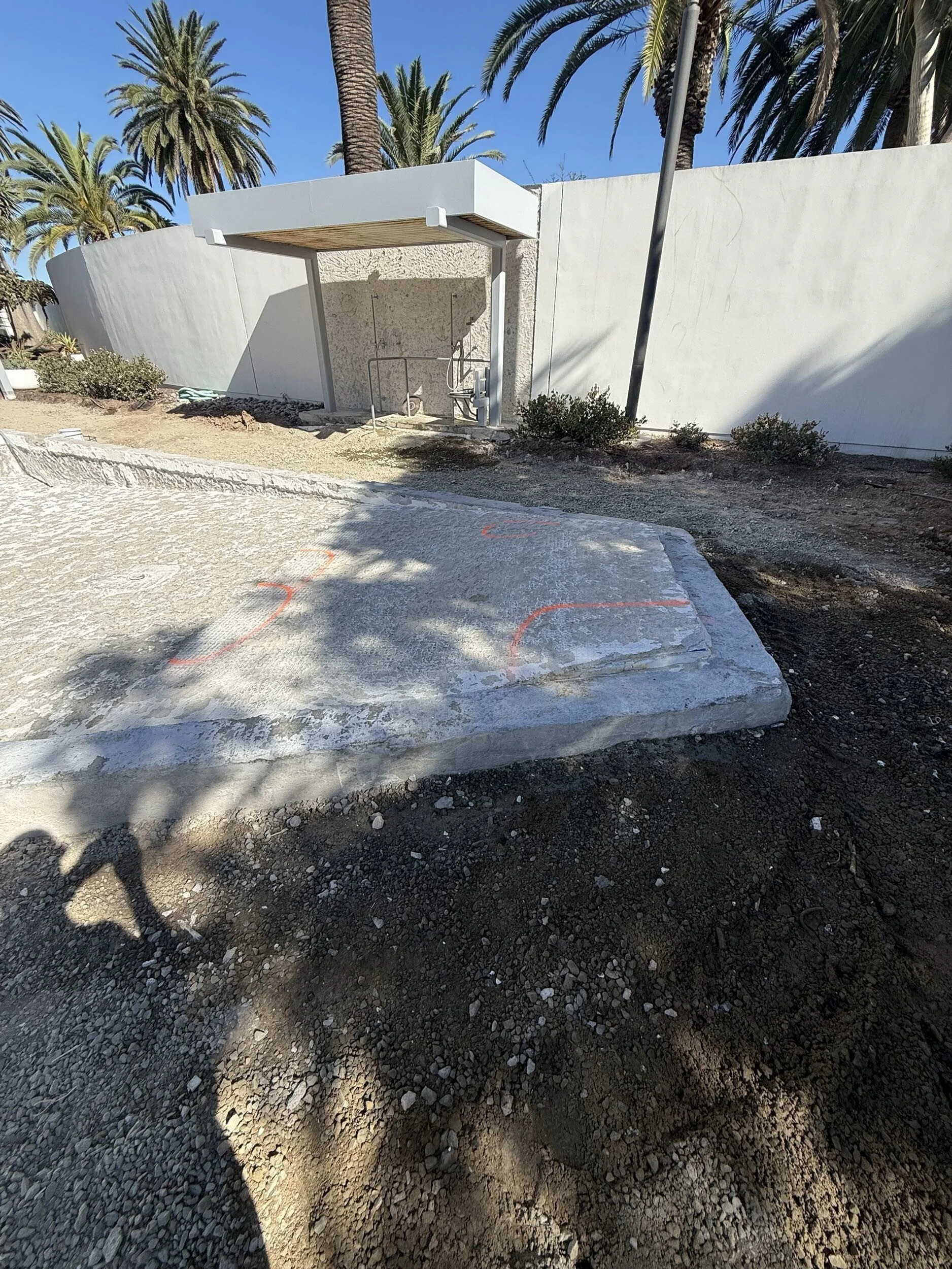

11/13/26 - Plumbing repairs to the shower valves have been completed, with mixing valve installation currently underway in all showers. Concrete block installation to recreate the raised steps around both spas and sub-deck installation are also complete. Looking ahead, road base will be added to prepare and level the deck areas for paver installation
11/6/2026 - This week, concrete was poured for the pool aprons, stair footings, and stairs, marking another major step forward in the renovation. The spas and jets were also tested to verify proper operation, and new drain covers were installed. Overall, construction continues to progress steadily with key infrastructure components now in place.

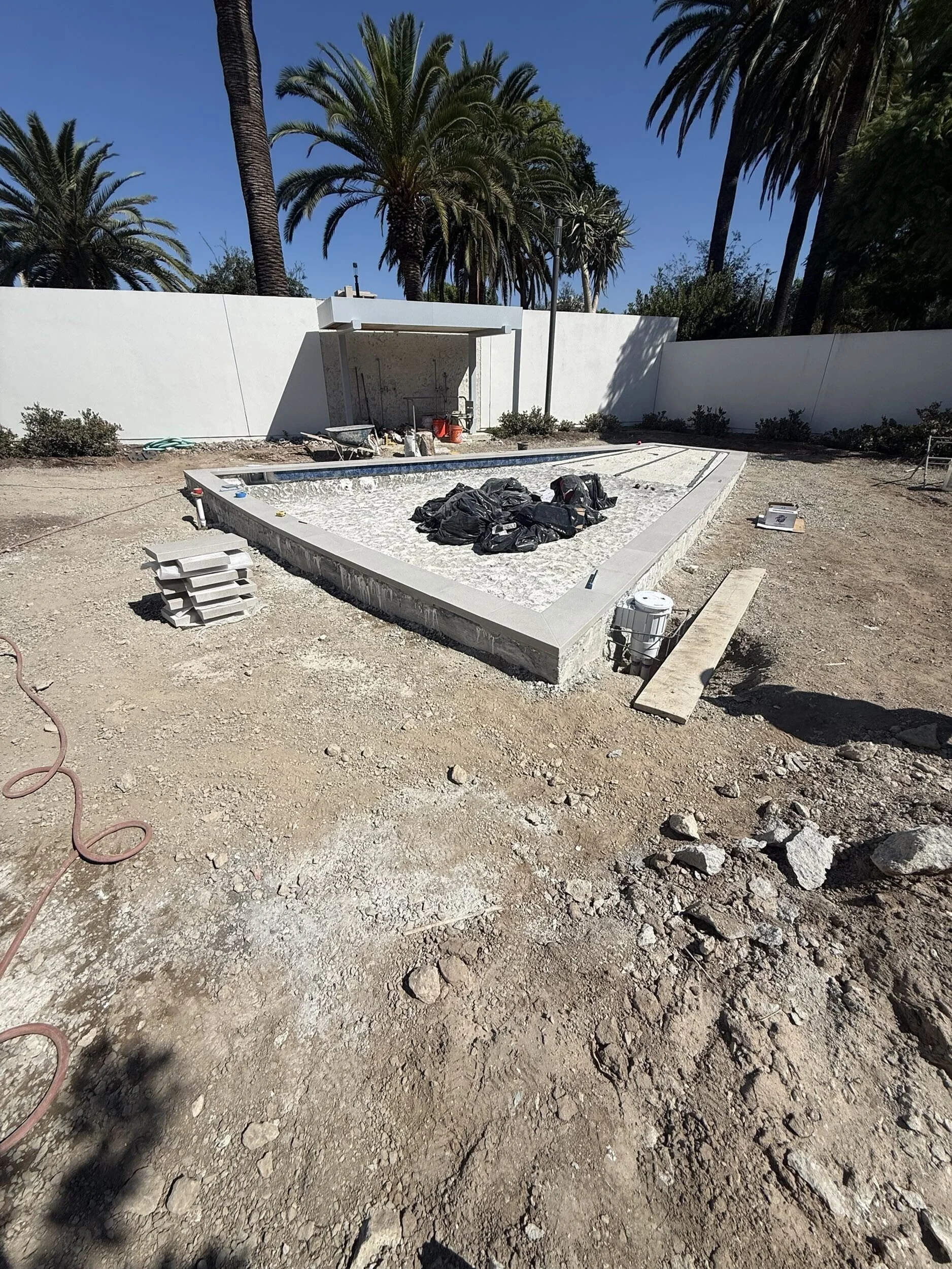

10/30/2026 - The project continues to progress on schedule. The city recently completed the deck pre-inspection, which was successfully passed. Aprons have now been installed around all five bodies of water, and electrical repairs have been completed throughout the site. Crews are currently focused on constructing the steps around the pool deck as the next phase of work moves forward.
10/23/26 The deck drains throughout the facility have been installed, and shotcrete has been completed for the wader pool, spas, and family pool. These areas are now ready for plaster, which is scheduled to take place closer to the end of the project. In the meantime, work continues to progress with the installation of the shower plumbing currently underway.
10/16/26 Pool progress continues across multiple areas of the project. Waterline and step tile installation have been completed in both the family pool and wader pool. Deck drains have been installed and are nearing completion, and road base has been placed on the upper deck. Demolition of both shower areas is complete, with plumbing preparation currently underway. The wader pool and spas are on schedule and ready for shotcrete next week.

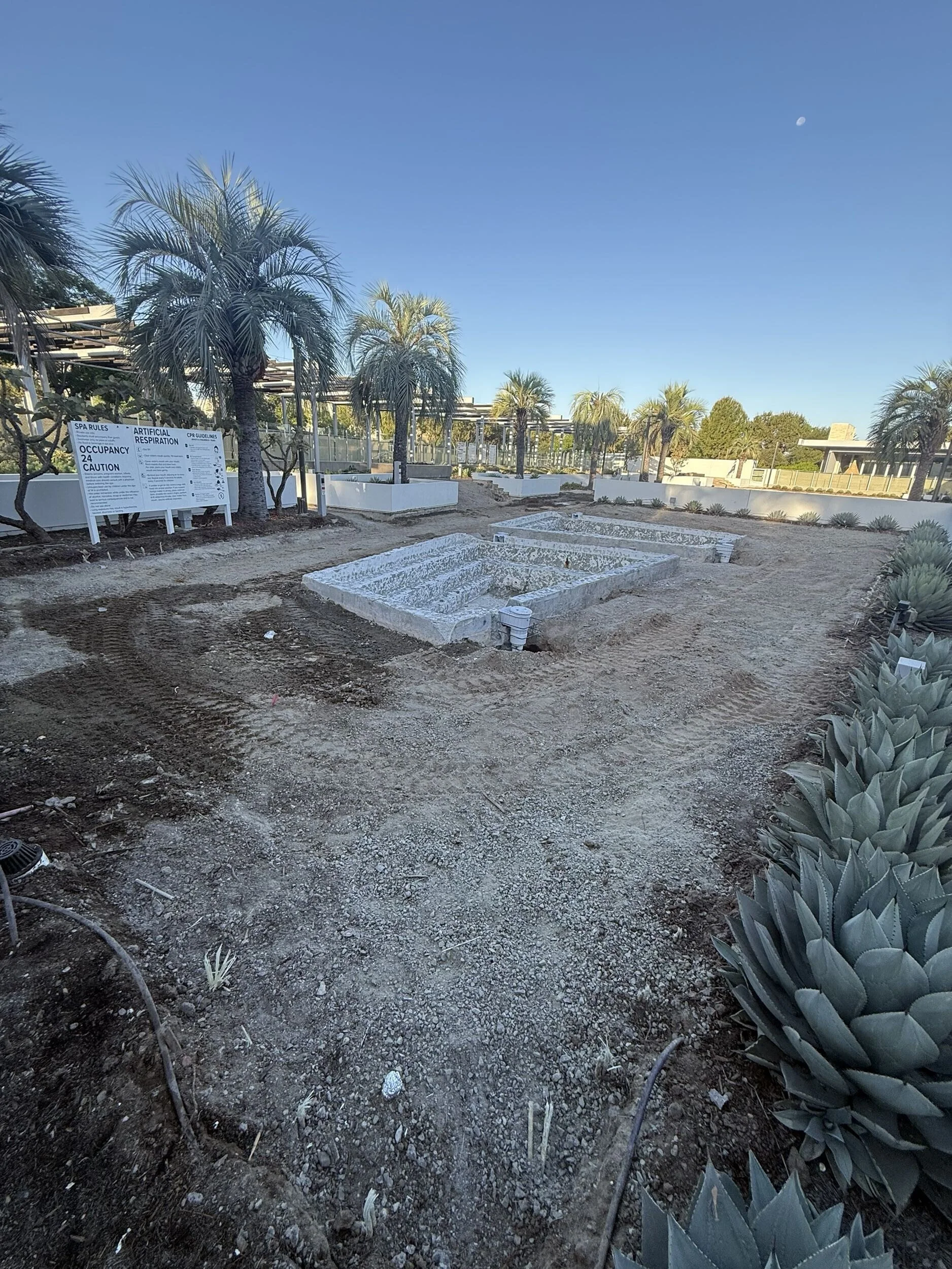

10/9/26 The pool coping has been installed around the family pool and wader pool. Waterline tile installation is underway in the family pool, while the wader pool waterline and ramp tile are also in progress. The family pool floor return fitting has been installed, patched, and finished with trim tile. Additionally, a separate crew is installing approximately 500 linear feet of drainage, with trenching and drain installation currently in progress.

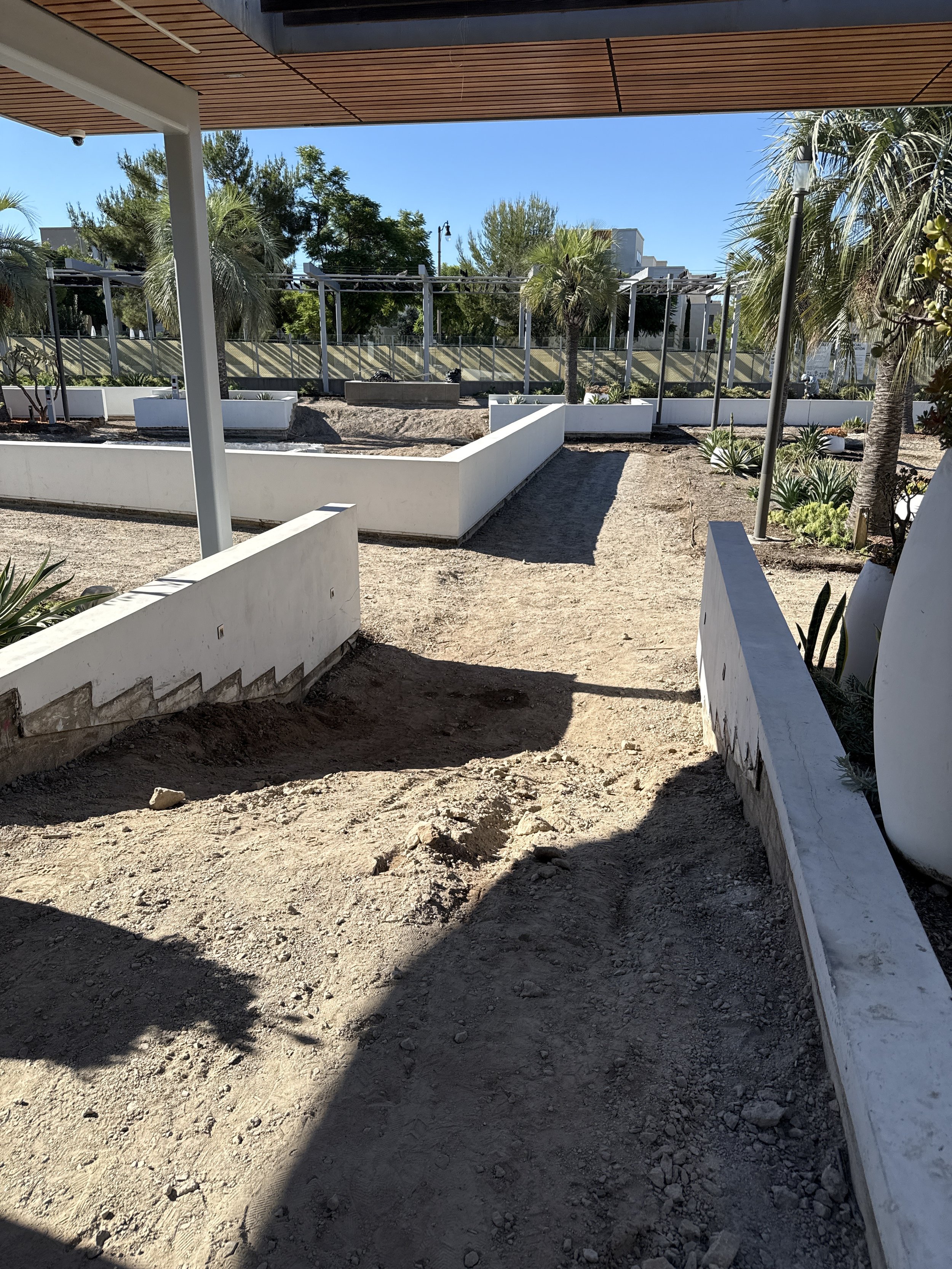

10/2/26 - This week, the leak detection test was completed, followed by a cleanup of the site after the demolition. Waterline tile, trim tile, and coping were delivered to the site, and eye hooks were installed in all bodies of water. The crew has begun leveling the upper deck in preparation for the installation of the deck drains. In conjunction with this work, a separate crew is preparing the areas for coping installation.

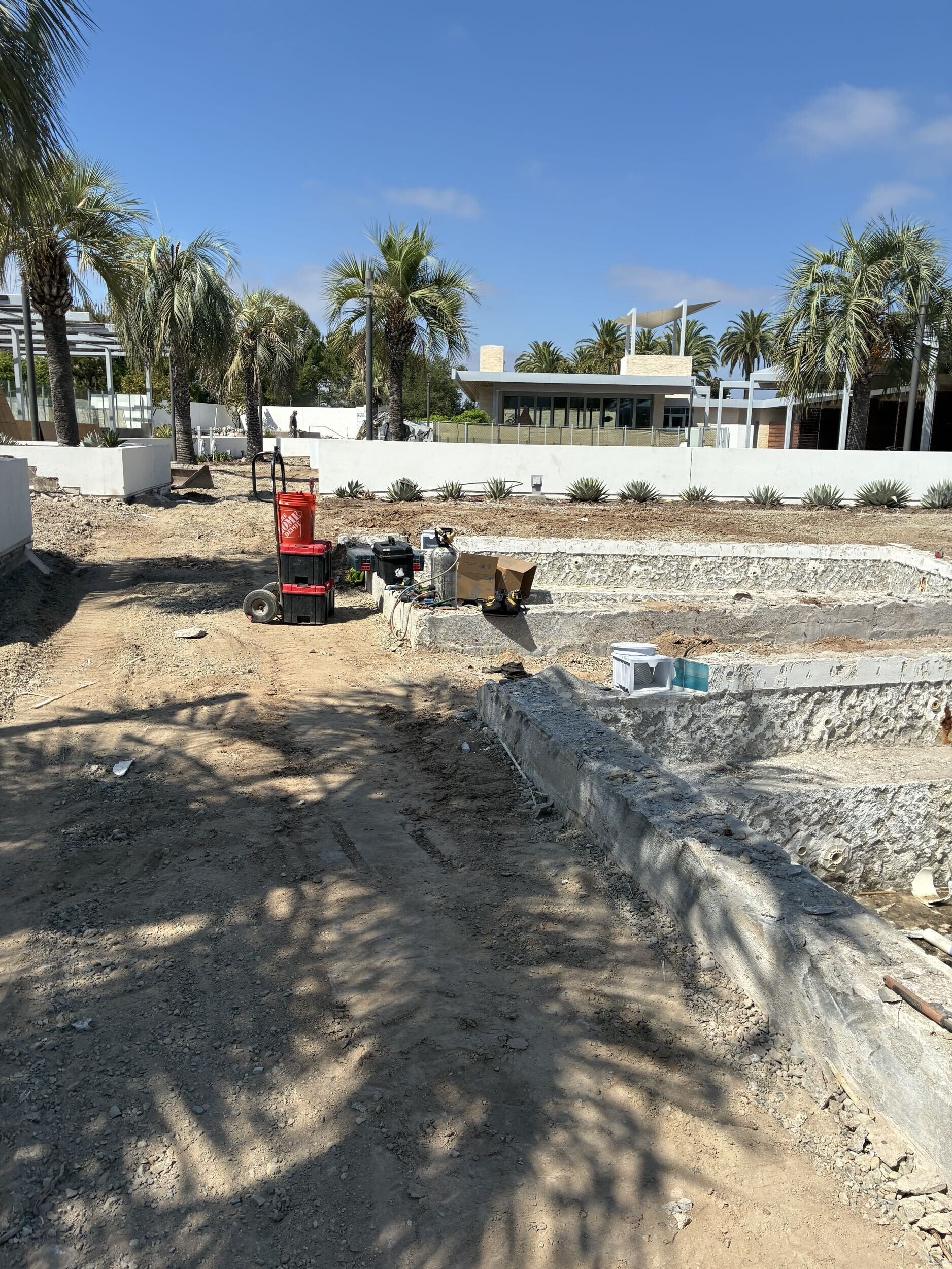

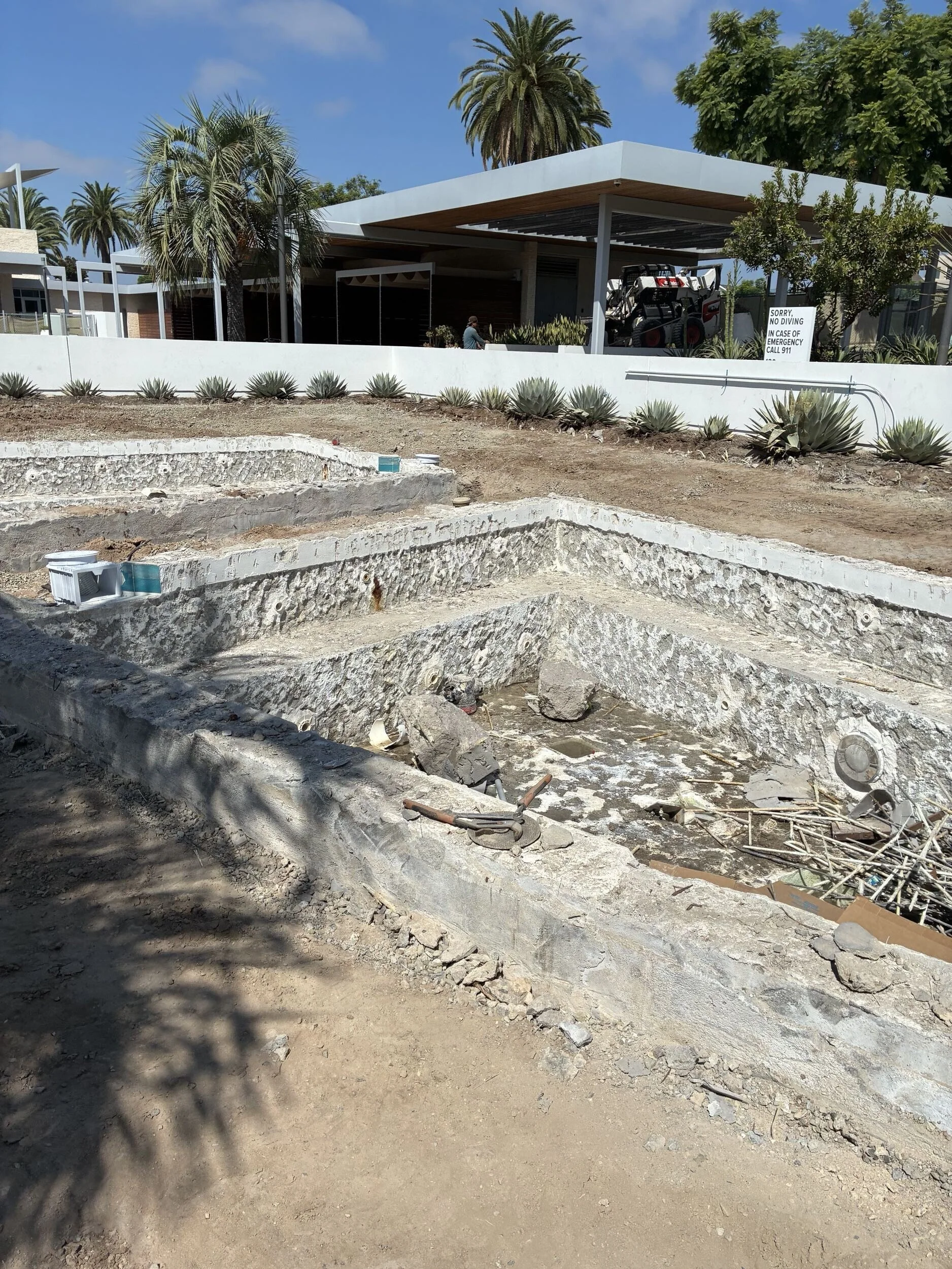

9/25/26 - Demolition work is expected to be completed by the end of today. Skimmers have been installed in all bodies of water, and leak detection is currently in progress. The shower flooring has also been demolished.

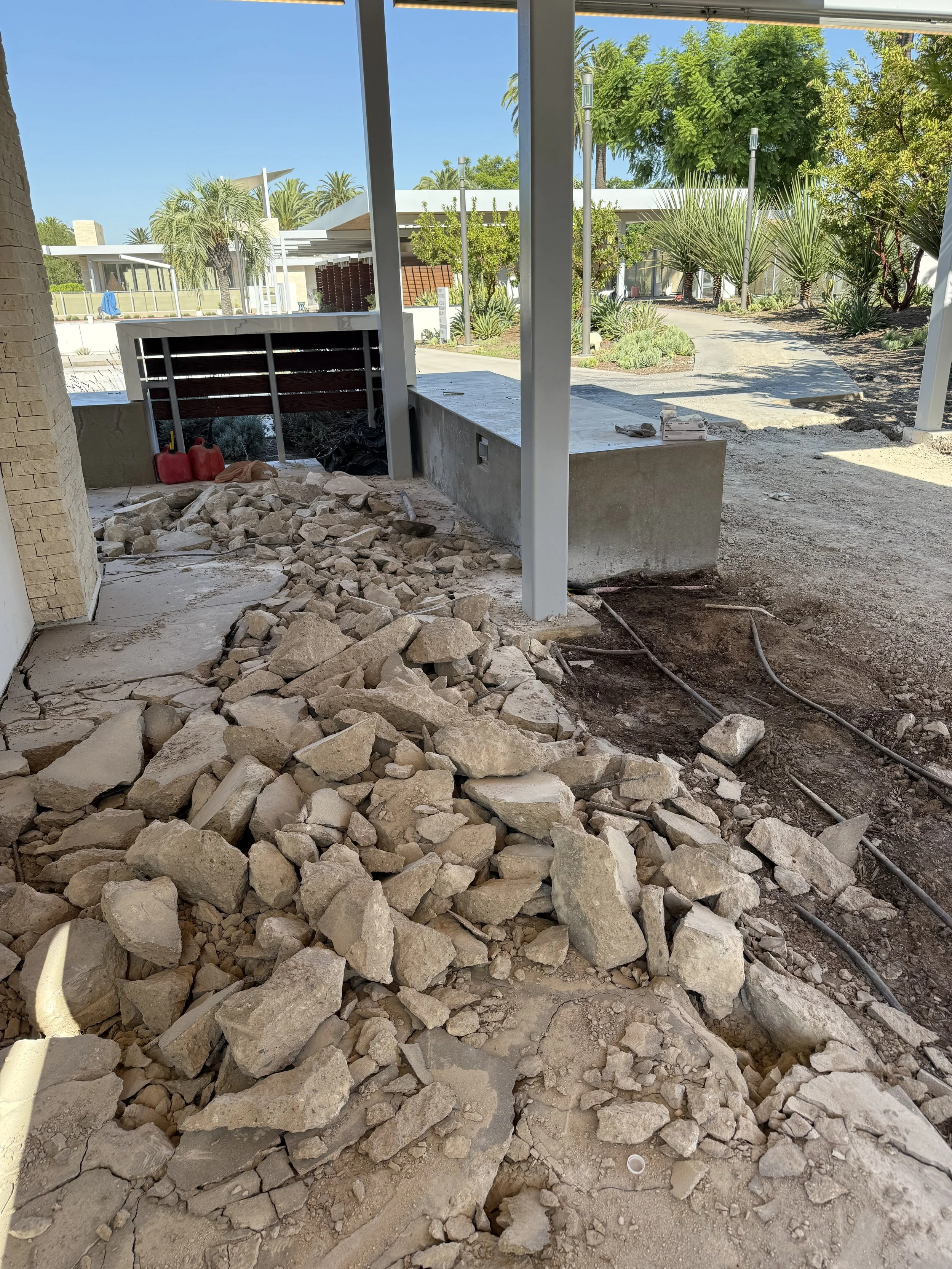

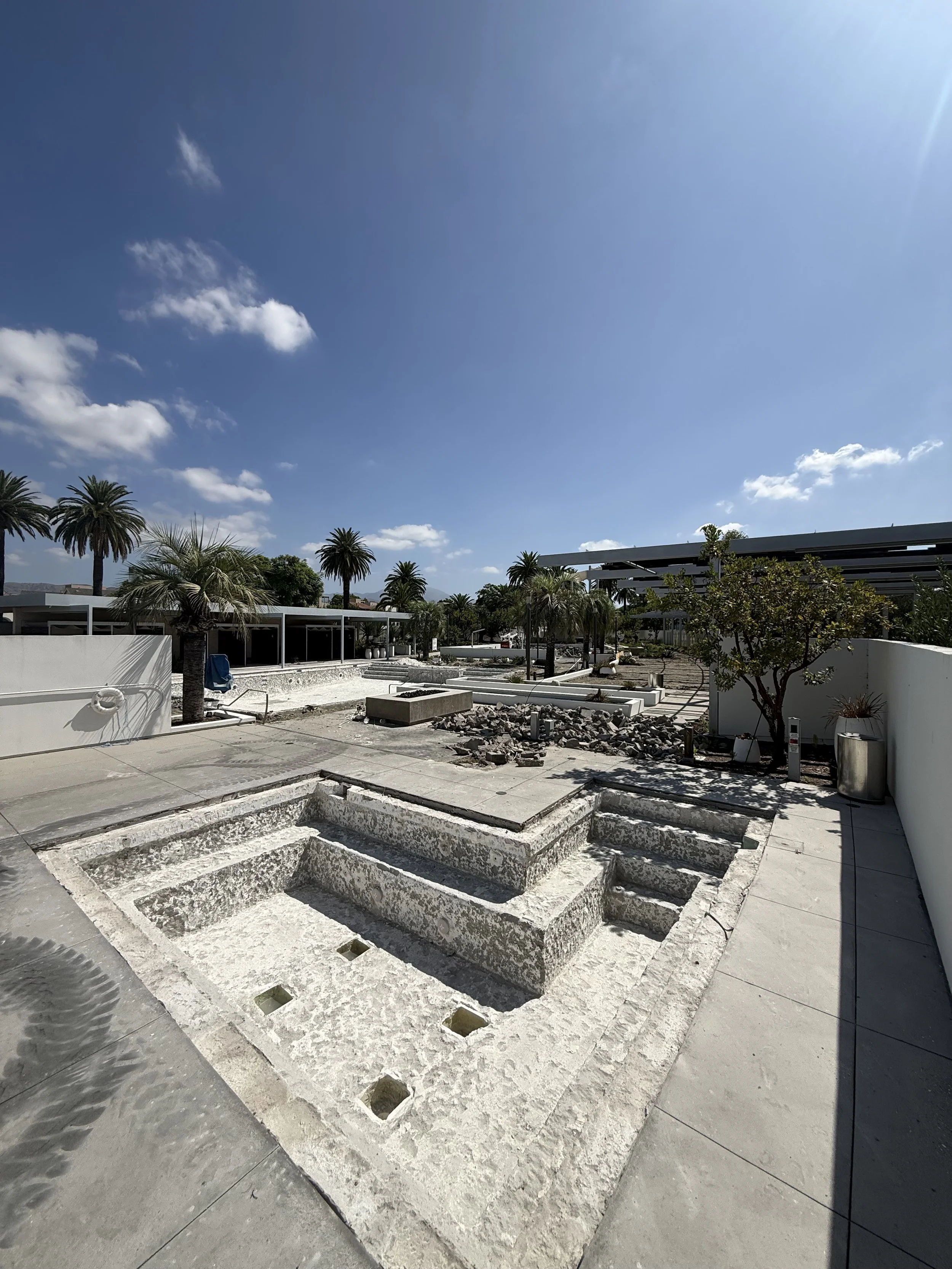

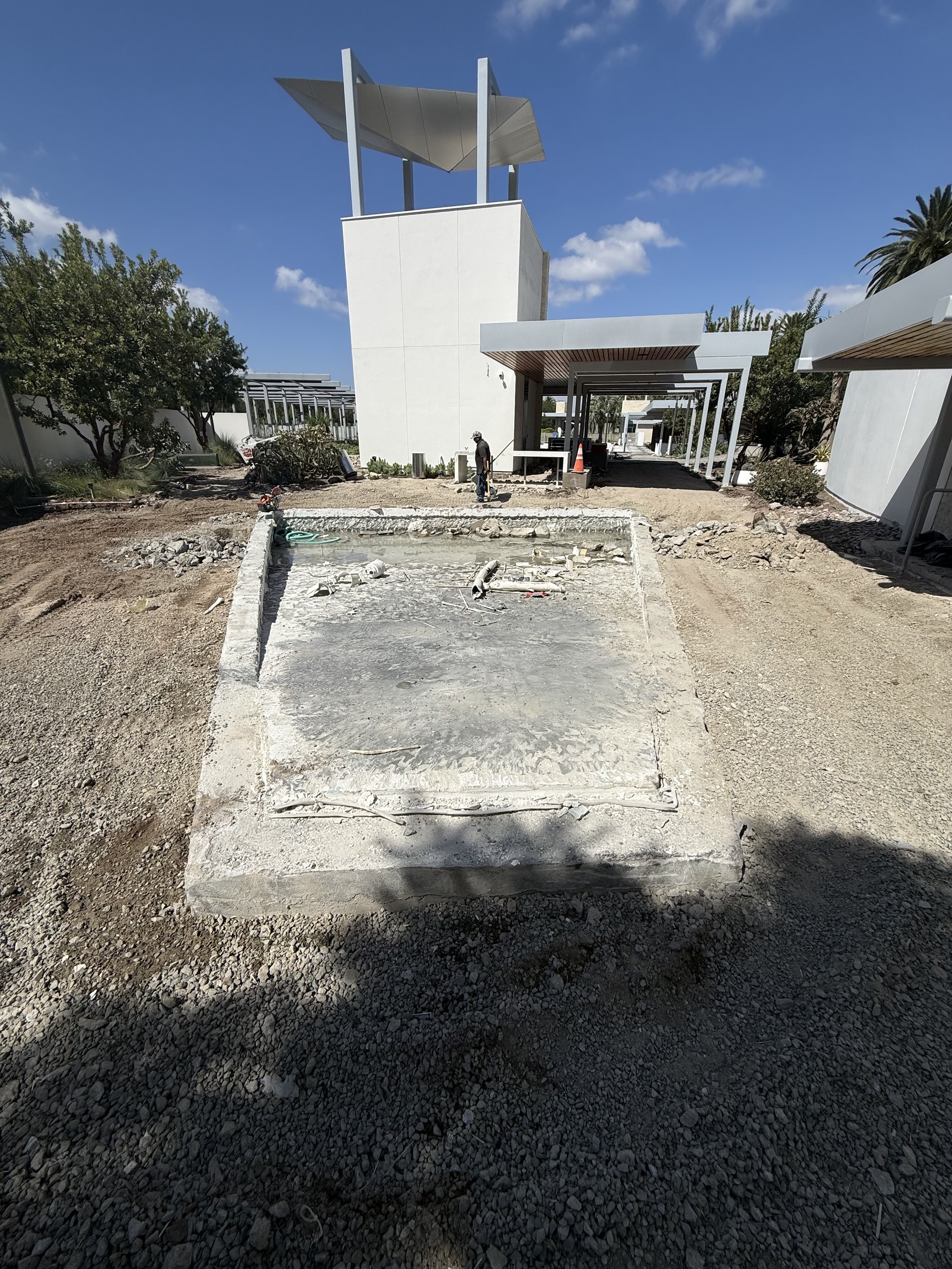

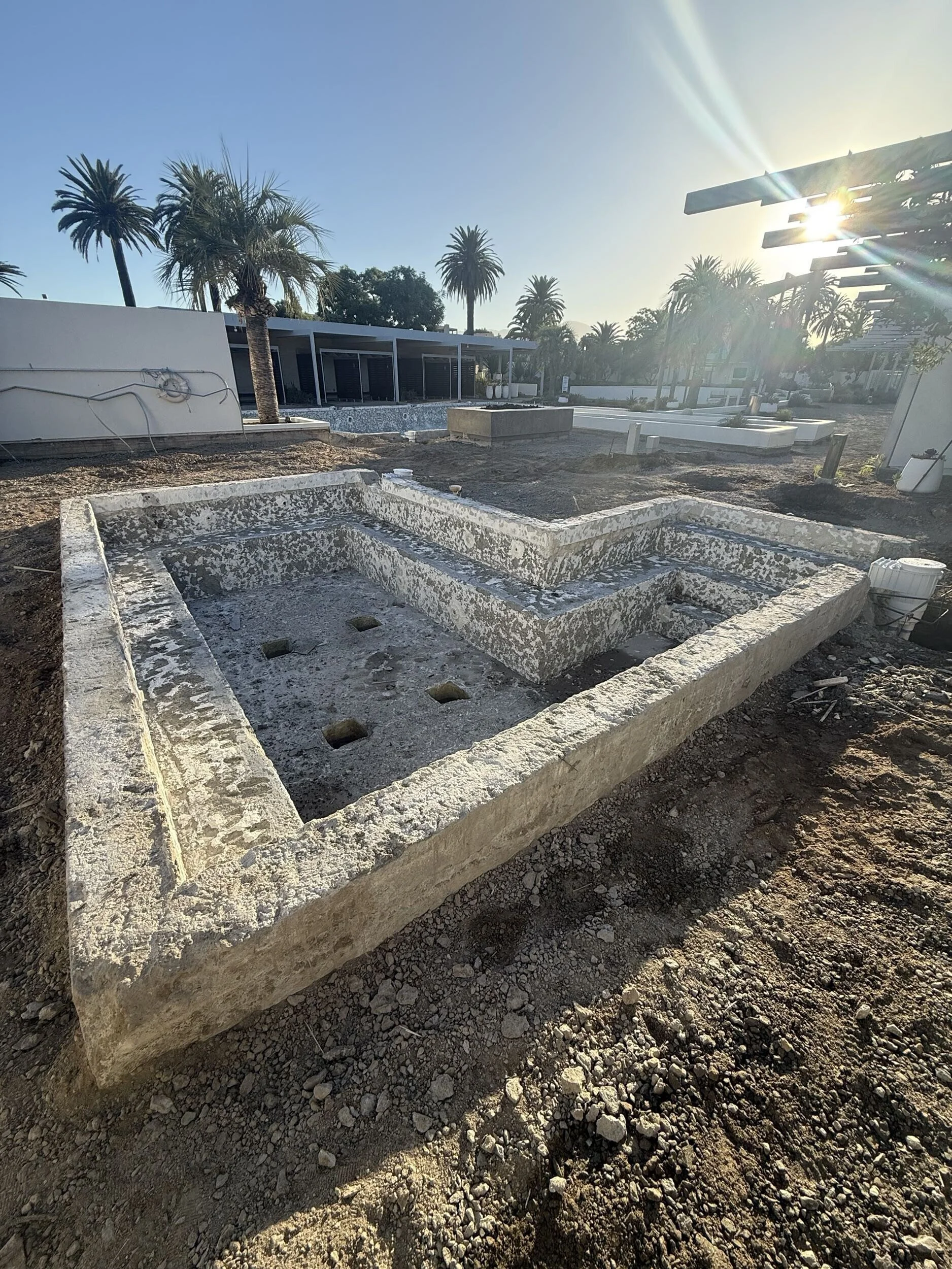

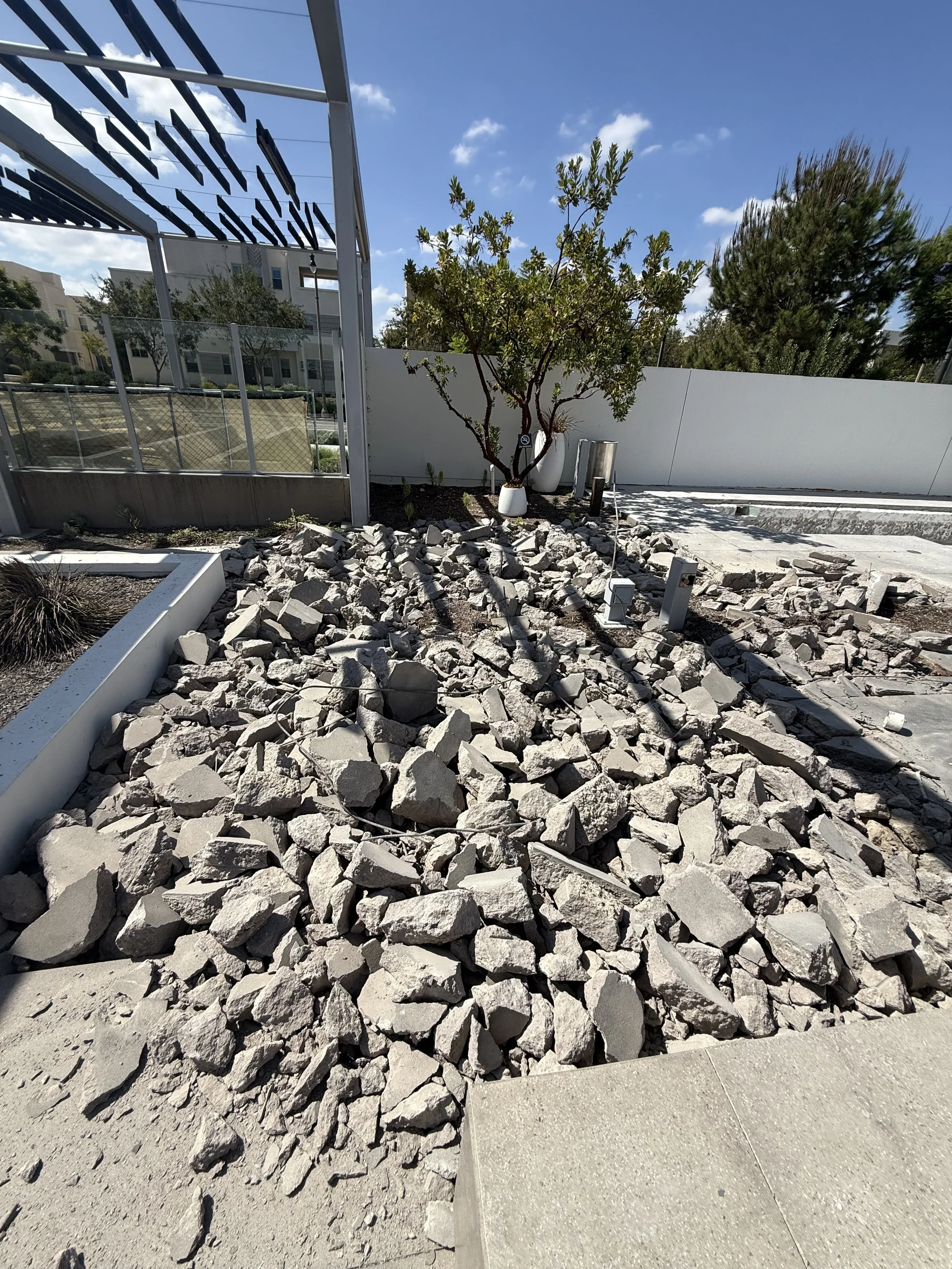

9/18/26 - The demolition and chipping of the Family Pool, wader pool, and three spas has been completed. This work included the removal of the plaster, tile, and coping. The demolition of the tile in both shower areas has also been completed. Concrete deck removal continues throughout the facility.

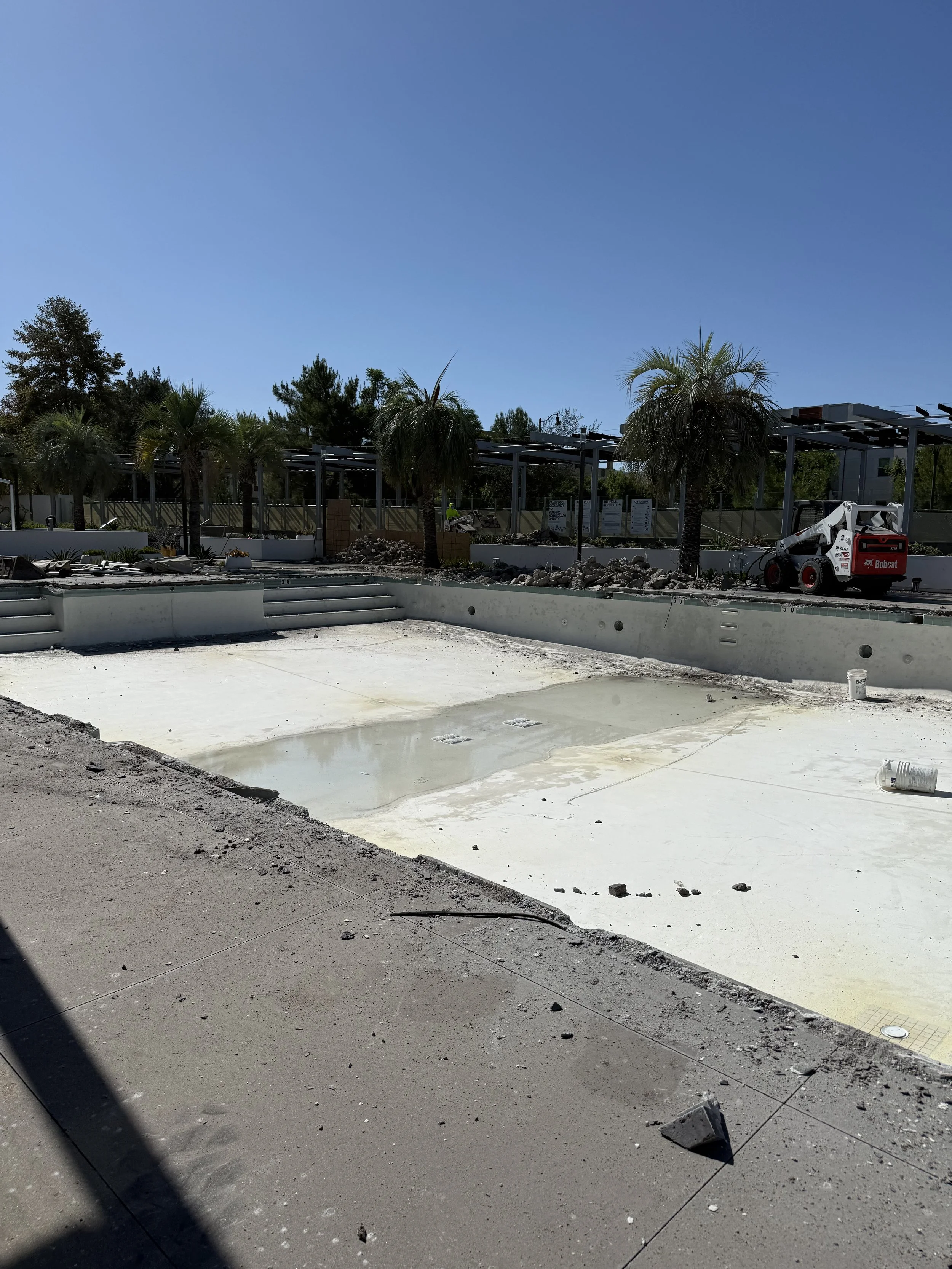

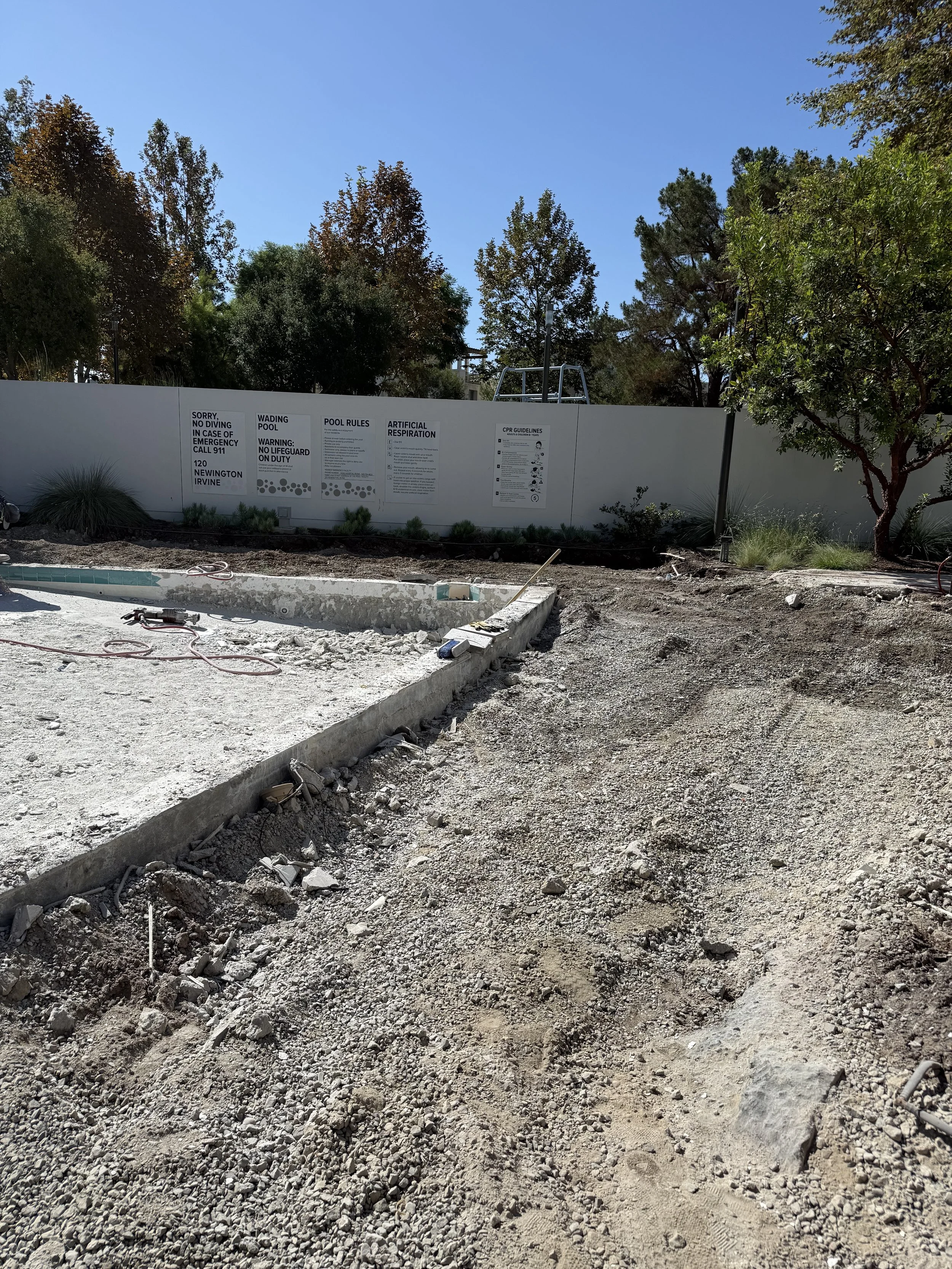

9/11/26 - Pool renovation work began on September 8 with the draining of all five bodies of water.
At the same time, pool furniture was removed and securely stored to clear the pool decks and prepare the area for construction activities.

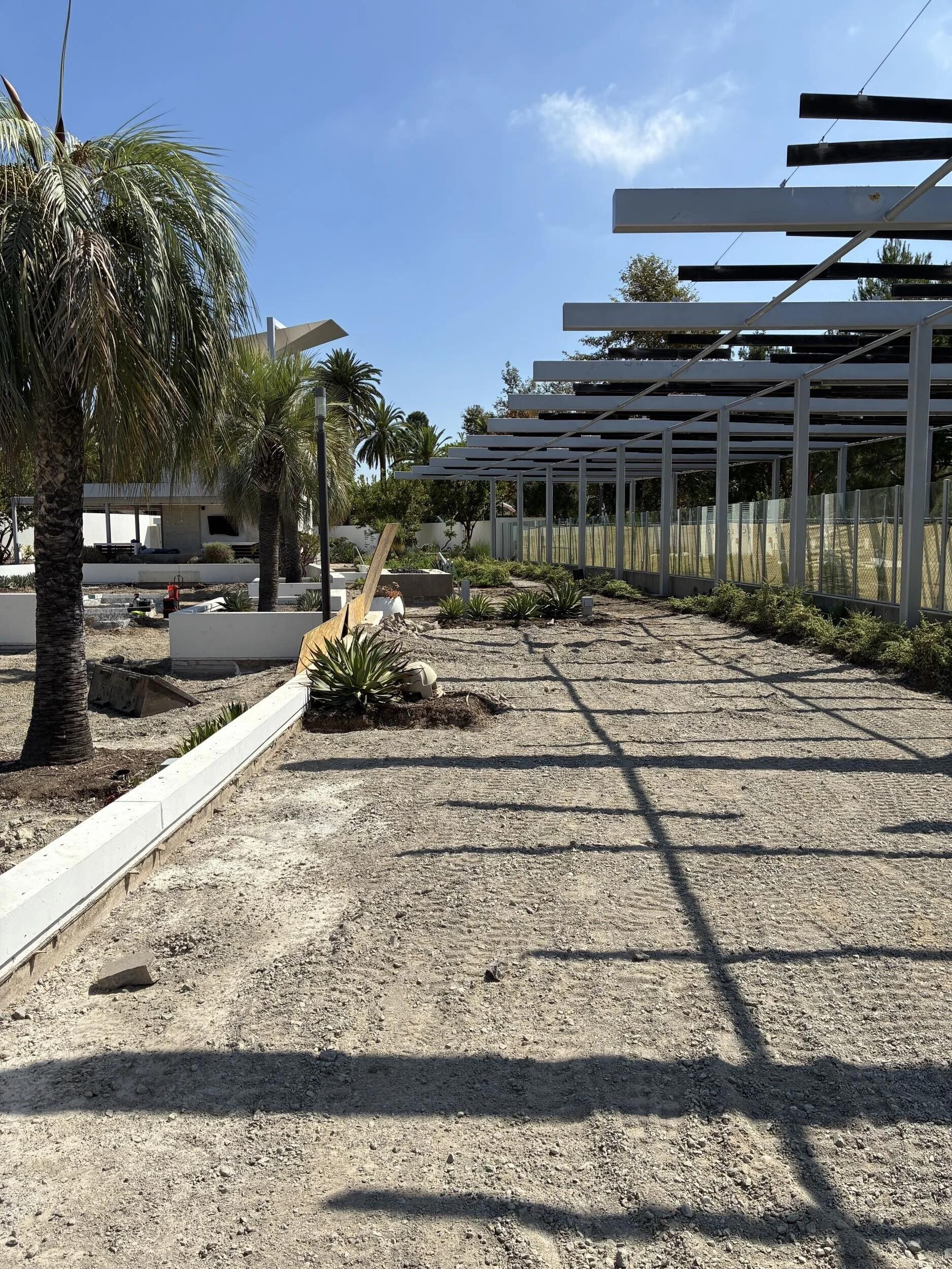

Temporary construction fencing was installed around the perimeter of the pool area to maintain site safety and secure the work zone throughout the renovation process.
Demolition activities commenced as scheduled, with crews making significant progress during the first week of work. The wader pool concrete demolition has been completed, and both spa areas and the wader pool have been fully chipped in preparation for the next phase of the project.
Demolition work has also begun in the shower areas.
